Product · Complete line

Complete activated carbon line — 0.5 to 3 t/h, from shell to packed carbon

Seven stages under one design: drying, carbonization, activation, washing, drying, screening and packing. One supplier, one performance figure, one number to call when something drifts.

Capacity
0.5–3t/h
Covered area
800–2,500m²
Delivery
120–150days
Reply within 24h · mass balance included · no obligation

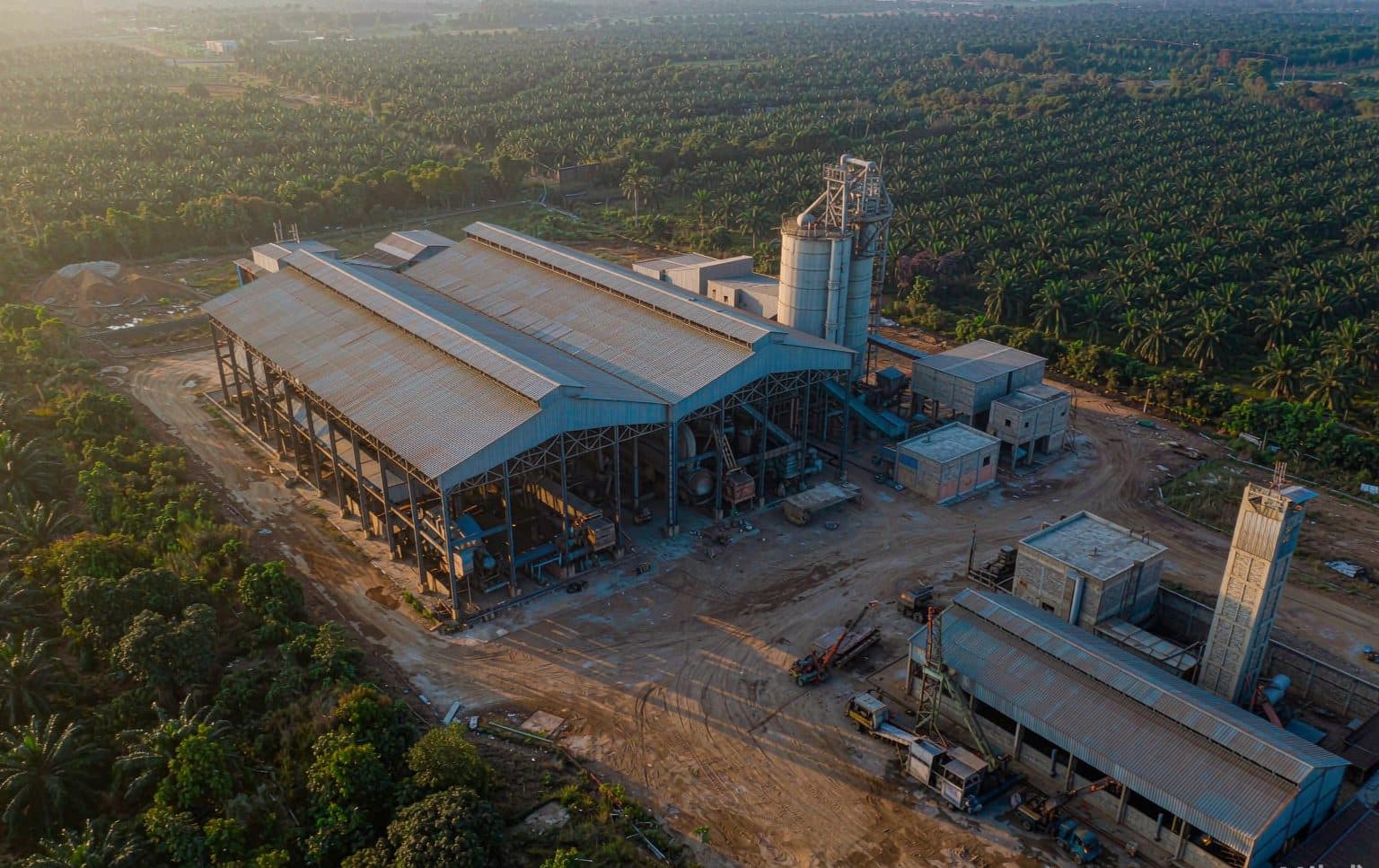

Complete activated carbon line: kilns, heat recovery and packing head
HL series · Henan, ChinaHL SERIES
180+lines supplied0.5–3 t/hfinished carbon, five models15–25 don-site commissioning2 yrmechanical warrantyEngineer-written answers, not sales copy

Key specifications

Reference configuration, 1 t/h finished carbon from coconut shell.
ParameterValue
Finished output1.0 t/h · 24 t/day · ~7,200 t/year at 300 days
Raw shell input5.0–5.5 t/h at 12% moisture
Total installed power380–450 kW
Steam demand1.8–2.2 t/h at 0.8 MPa (from waste-heat boiler where fitted)
Process water8–12 m³/h, plus 3–5 m³/h make-up for washing
Fuel (after start-up)0–40 m³/h natural gas, depending on heat recovery
Covered area30 × 32 m main bay + 12 × 20 m raw material shed
Tallest structure12 m (shaft furnace variant) / 9 m (rotary variant)
Operators2 per shift, 3 shifts
Delivery120–150 days from down payment
Erection and commissioning20–30 days, 4–6 technicians on site
Performance test72-hour continuous run at rated capacity and iodine value

The seven stages, and what each one is for

1 · Raw material preparation

Shell is received, weighed, screened and crushed to the target band — 3–12 mm for granular product. Fines below 3 mm are separated here, not later: they are what choke a shaft furnace and what burn off in a rotary kiln.

2 · Drying

A rotary dryer brings shell from 12–18% moisture down to below 8%. Skipping this stage costs you 10–15% of carbonization throughput, because the kiln spends its heat on water instead of on pyrolysis.

3 · Carbonization

Oxygen-deficient pyrolysis at 450–550 °C, 28–34% char yield. Volatiles are burned in a secondary chamber and returned as process heat.

4 · Activation

Rotary kiln or shaft furnace at 850–1,100 °C with superheated steam. This is where iodine value and pore structure are set, and where the choice of furnace type matters most.

5 · Washing or acid treatment

Water washing removes ash and lowers pH; acid washing (hydrochloric, sometimes with caustic) is used for low-ash or food-grade product. This stage is optional and should be quoted separately, because it changes the effluent design.

6 · Drying and screening

Centrifugal dewatering then a rotary or flash dryer to below 5% moisture, followed by vibrating screens into 4×8, 8×16 and 8×30 mesh cuts. Undersize returns as product for the powder market rather than as waste.

7 · Packing

25 kg bags, 500 kg jumbo bags, or bulk. Dust extraction at the packing head is not cosmetic — it is the difference between passing and failing an environmental inspection.

Where the capital goes, 1 t/h line

Share of total equipment and installation cost, turnkey scope. Site civil works vary with local conditions and are excluded.
PackageShareNote
Carbonization + activation main equipment42–50%The two kilns, burners, drives, linings
Material handling and storage10–14%Screening, conveying, hoppers, dryer
Steam and heat recovery9–13%Boiler, superheater, ducting, ID fans
Washing, drying, screening, packing11–15%Optional but usually needed for export product
Electrical and control7–10%PLC, MCC, cabling, instrumentation
Environmental8–12%Secondary combustion, cyclone, scrubber, dust collection
Erection, commissioning, training6–9%Included in turnkey scope

Build it in two phases, not one

Almost every buyer who insists on a full line from day one ends up with idle equipment. Phase one should be carbonization plus activation plus screening — enough to make and sell granular carbon. Phase two adds washing, drying and packing when the order book justifies it.

The reason is cash flow, not caution. A complete 1 t/h line takes 120–150 days to deliver and 20–30 days to commission; add financing, raw material inventory and the first shipments, and you are 8–10 months from the first invoice. Splitting the build means the kilns start earning four months earlier, and the second phase is then funded by production rather than by more debt.

The one thing to get right at phase one is space and utility capacity. Leave the footprint, the transformer capacity and the effluent routing for the washing stage, or phase two becomes a demolition project.

What a turnkey scope includes

  • Process design, mass and heat balance, and equipment layout drawings.
  • All process equipment from feed hopper to packing head, including linings cast and cured before dispatch.
  • Electrical design, PLC and MCC cabinets, instrumentation and cabling schedules.
  • Structural steel, platforms, and foundation load drawings for the civil contractor.
  • Erection supervision, commissioning, 72-hour performance test and operator training.
  • Two-year spare parts list and a recommended spares package.
  • Capacity, iodine value and yield are written into the contract and verified at the performance test.

What a turnkey contract should never leave vague

Three numbers decide whether the plant works: the basis of the capacity figure (finished carbon or char feed), the moisture of the shell it assumes, and the iodine value at which the tonnage applies. A contract that does not state all three cannot be enforced. The contract here states all three, and the performance test is written against those three numbers rather than against a general statement of good faith.

Questions buyers ask before ordering

Straight answers with numbers. If yours is missing, send it over.

How much does a complete line cost?
A 1 t/h turnkey line — drying, carbonization, activation, washing, drying, screening, packing and environmental controls — typically falls in the range of USD 1.2–2.0 million depending on the furnace type, the degree of automation and how much of the washing stage you include. Rather than quote a single figure, we send a cost breakdown by package so you can see what each stage adds and decide what to defer.
How long until the line pays for itself?
At a 1 t/h output, 300 operating days a year and a selling price of USD 1,400–1,800 per tonne for granular coconut carbon, gross revenue is USD 10–13 million. Raw material, energy and labour typically absorb 60–70% of that. Most projects we are involved in show a payback of two to four years, driven mainly by shell cost and the iodine value you can hold.
Can I start with only the activation furnace and buy char?
Yes, and many do. Purchased char costs more per tonne of carbon than making it yourself, but it removes the carbonization capital and the operational learning curve. If char is reliably available within a few hundred kilometres, this is a legitimate way to start; if it is not, you are buying your raw material from a competitor.
What utilities do I need on site?
For 1 t/h: 380–450 kW of installed power (about 300 kW average draw), 1.8–2.2 t/h of steam at 0.8 MPa, 8–12 m³/h of process water plus make-up for washing, and a fuel connection that can deliver 40 m³/h of gas for start-up. A 500 kVA transformer and a 30 m³/h water line cover the usual configuration with margin.
How many people to operate it?
Two per shift across three shifts, plus one maintenance fitter and one lab technician for iodine value and moisture testing. That is a realistic figure for a 1 t/h line; below about 0.5 t/h, one operator per shift can run it, which is one reason small lines are attractive in remote locations.
Who handles installation?
We send four to six technicians for 20–30 days: a mechanical lead, an electrical and controls engineer, a refractory specialist and commissioning engineers. Local labour for rigging and civil work is supplied by you. The performance test is run at the end of commissioning, over 72 continuous hours, and signed against the contractual figures.
Sizing a line? Start with the mass balance.

Send the raw material, target tonnage and finished spec. You get a configuration, a utility schedule and a budget range — not a brochure.
